Overview

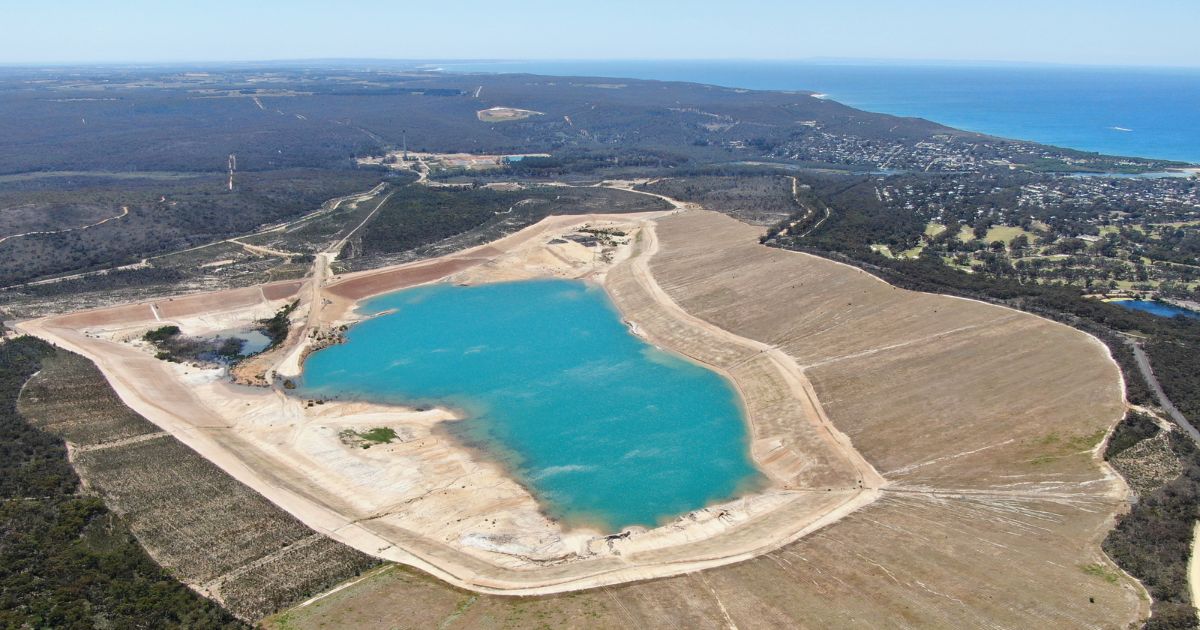

Southern Rural Water (SRW), the regional water authority responsible for southern Victoria, formally refused an application by Alcoa of Australia in July 2025 for a groundwater extraction licence at the former Anglesea open-cut coal mine. Alcoa had sought to extract 1,500 megalitres of groundwater per year over a 10-year period from the Upper Eastern View Formation aquifer, with the extracted water intended to accelerate the filling of the open mine void as part of the company’s Mine Closure and Rehabilitation Plan. The decision was published on 17 July 2026 and represents one of the more consequential water licensing refusals in Victorian post-mining history in recent years.
The mine void filling was a critical precursor to the proposed Eden Project Anglesea, a tourism and commercial development reportedly valued at $150 million. SRW’s Managing Director, Scott Cornish, stated publicly that the mine pit is projected to fill naturally within 26 years and that the limited benefits of accelerating that timeline did not justify the environmental risks to the Anglesea River catchment. The determination followed a rigorous assessment process that attracted 167 public submissions, a public hearing, and independent technical panel reviews, making it an unusually well-scrutinised licensing decision for a regional water authority.
For environmental consultants, hydrogeologists, mine closure planners, and the developers and lawyers who rely on their advice, this decision signals a material shift in how Victorian regulators are weighing catchment-scale ecological risk against commercial rehabilitation timelines. The case raises immediate questions about void-filling strategies at other post-mining sites across Australia and about how water licensing risk should be factored into transaction due diligence and mine closure feasibility from the outset.
Key details of the SRW determination and Anglesea River acid risk findings
Alcoa’s proposed extraction rate of 1,500 megalitres per year equates to approximately 1.5 billion litres annually, or roughly the equivalent of 600 Olympic-sized swimming pools. Drawn from the Upper Eastern View Formation aquifer over a decade, this volume was modelled to reduce the natural 26-year void-filling timeline to a much shorter period. SRW’s assessment concluded that this extraction rate would cause small but potentially significant reductions in shallow groundwater levels and river base flows across the Anglesea River catchment, a finding that proved decisive in the refusal.
The Anglesea River is a naturally acidic and ephemeral system, meaning it experiences extended periods of low or zero flow under natural conditions. This combination of acidity and intermittent flow makes the catchment especially vulnerable to acid flush events, which occur when accumulated acidic and metal-laden water is rapidly flushed into the river following low-flow or no-flow periods. SRW determined that groundwater drawdown from Alcoa’s proposed extraction would increase the frequency and duration of no-flow days in the river, compounding the risk of these acid flush events and the associated aquatic ecological damage, including fish kills. The assessment applied the Australian and New Zealand Guidelines for Fresh and Marine Water Quality 2018 (ANZG 2018) framework to evaluate the risks of acid generation, heavy metal mobility, and harm to aquatic ecosystems.
The determination was made under the Water Act 1989 (Vic). Section 40 of that Act requires the minister or delegate to consider the protection of waterways and aquifers when assessing licence applications. SRW’s independent technical panels and submissions panel both contributed to the final assessment, and the weight given to the 167 public submissions reflected the community and ecological values attached to the Anglesea River system. The broader regulatory context also includes the Environment Protection Act 2017 (Vic), which establishes the General Environmental Duty (GED) requiring duty holders to minimise risks of harm to human health and the environment so far as reasonably practicable. SRW’s refusal is consistent with how the GED has been interpreted by Victorian regulators since the EP Act 2017 came into full effect in July 2021.
Without the groundwater extraction licence, Alcoa must rely on natural inflow processes to fill the mine void, a timeline of approximately 26 years from the date of cessation of mining activities. This extended filling period has direct and immediate consequences for the Eden Project Anglesea, which required the filled void as a foundational site condition. The commercial feasibility, planning approval pathway, and investment case for that development are now materially affected by the water licensing outcome, illustrating how regulatory decisions on groundwater can dictate land-use feasibility for post-mining redevelopment proposals.

Australian context: groundwater licensing, mine closure, and catchment-scale risk in Australian regulatory frameworks
This decision sits squarely within a broader national trend toward more rigorous scrutiny of groundwater extraction proposals that intersect with groundwater-dependent ecosystems (GDEs). Across Australian jurisdictions, environmental regulators and water authorities have increasingly required applicants to demonstrate catchment-scale hydrological baseline data and multi-year predictive modelling before large-volume extraction licences are granted. The National Water Initiative, to which all Australian states and territories are signatories, requires that water planning frameworks protect GDEs and maintain ecological values of water-dependent ecosystems. SRW’s refusal of the Alcoa licence is a clear application of these principles at the licensing decision stage.
